Lift Station Planning for Remote Data Center Sites

A guide to planning, designing, and permitting sewage lift stations for remote data centers. Learn about sizing, redundancy, backup power, and regulatory compliance for mission-critical sites.

Lift Station Planning for Remote Data Center Sites

Identifying the Need for a Wastewater Lift Station

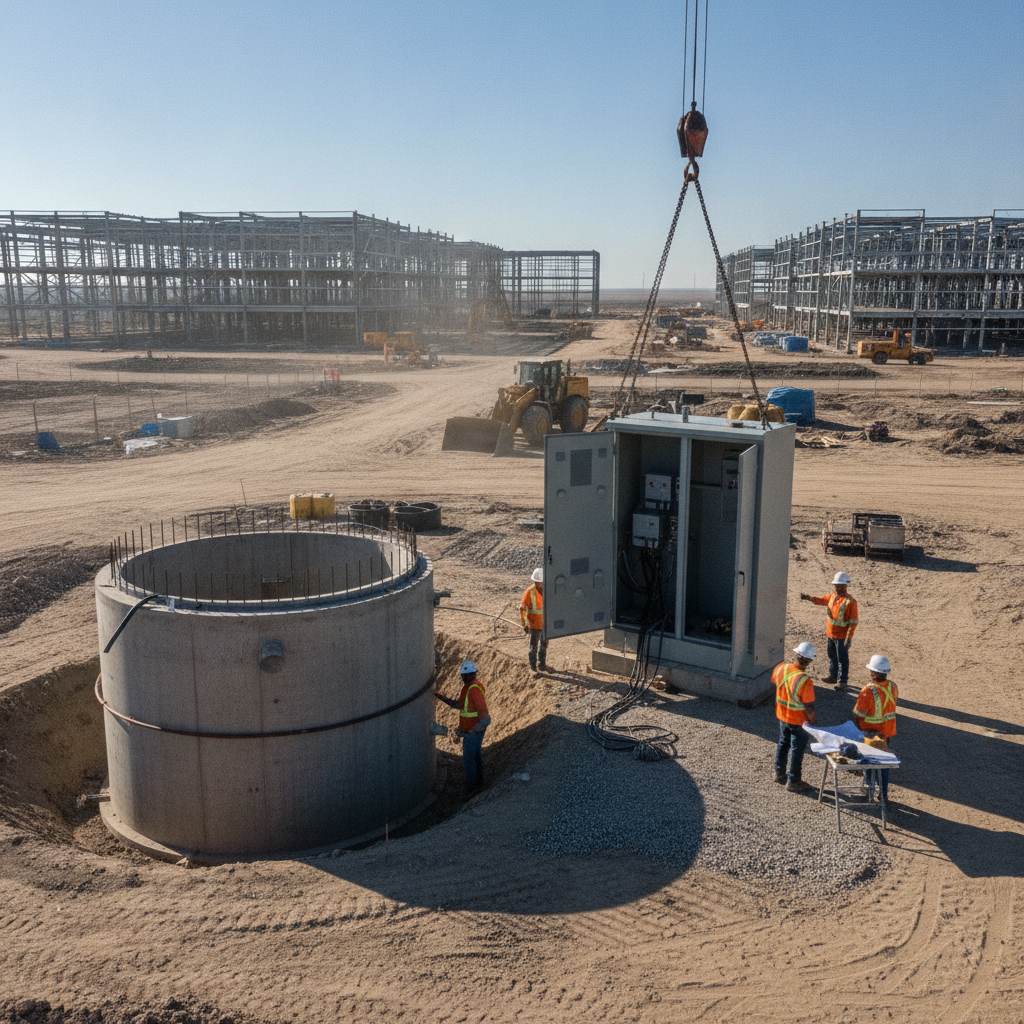

The fundamental driver for a lift station is topography. A standard sanitary sewer system relies on gravity sewer lines, which are sloped to allow wastewater to flow downhill to a treatment facility. When a development site sits at a lower elevation than the nearest public sewer main, or is separated by intervening high ground, a lift station is required to pump the sewage uphill through a pressurized force main. A thorough topographic survey and initial utility coordination are the first steps in determining this necessity. Data center developers often select large, rural parcels to accommodate massive building footprints, cooling infrastructure, and security perimeters. These locations are frequently miles from established utility corridors. The civil engineer’s role is to evaluate the feasibility and cost of extending a gravity sewer versus designing a self-contained lift station. In most remote site scenarios, the lift station is the only viable engineering solution, making its design a critical path item for the entire project schedule.

Core Components and Sizing Calculations

Lift Station Design Parameter Comparison

Design ParameterStandard Commercial SiteMission-Critical Data Center Site
Pump ConfigurationDuplex system (one duty, one standby) is common.Duplex or triplex system with 100% redundancy. Pumps specified for high reliability and long service intervals.
Power SourceConnected to standard utility power. Backup power connection may be optional.Connected to both utility and facility backup generator power via an automatic transfer switch (ATS). UPS for control panel is often required.
Monitoring & AlarmsLocal alarms (strobe light, horn). Basic autodialer for off-site alerts.Full SCADA integration with the facility's Building Management System (BMS). Provides real-time pump status, flow rates, run times, and predictive failure alerts.
Wet Well MaterialPrecast concrete is standard.Precast concrete with corrosion-resistant liners or coatings to extend service life and ensure structural integrity.
Odor ControlPassive carbon filters may be used if required.Active odor control systems (carbon or biological scrubbers) and sealed, gasketed hatches are standard to prevent any impact on facility operations or personnel.
SecurityTypically secured by a standard chain-link fence.Integrated into the data center's comprehensive security plan, including perimeter fencing, access control, and camera surveillance.

A wastewater lift station is a complex system with several key components that must be engineered to work in concert. The primary structure is the wet well, a subterranean basin that collects incoming wastewater. Inside the wet well are two or more submersible pumps, typically in a duplex pump system configuration. This system is managed by a sophisticated control panel that monitors liquid levels and alternates pump operation. Proper wet well sizing is crucial; it must be large enough to prevent pumps from short-cycling (turning on and off too frequently) but small enough to ensure wastewater does not sit long enough to become septic. The design capacity is based on calculating the peak wastewater flow, which is determined by the facility’s projected water usage from restrooms, kitchens, and other plumbing fixtures. Engineers use fixture counts and established engineering standards to model peak demand. The pumps are then selected to handle this peak flow, and the system is designed for optimal pump cycling to maximize equipment lifespan and minimize energy consumption. This detailed analysis ensures the system can handle maximum load without being over-designed, which would incur unnecessary capital and operational costs.

Ensuring Uptime: Redundancy and Backup Power

For a mission-critical facility like a data center, a single point of failure is unacceptable. Lift station design must mirror the facility’s overall resilience strategy. This starts with redundant pumps. In a typical duplex system, one pump serves as the primary (duty) pump while the other is on standby. If the duty pump fails or cannot keep up with inflow, the standby pump automatically activates. The control system also alternates between pumps to ensure even wear over time. Equally important is the connection to a reliable backup power source. The lift station’s control panel and pumps must be connected to the data center’s emergency generator and, in some cases, an uninterruptible power supply (UPS) to ensure continuous operation during a power outage. Furthermore, modern data center lift stations require robust monitoring and alarm systems, often with SCADA integration. These telemetry systems provide real-time status updates and send immediate alerts for high water levels, pump failures, or power loss, allowing facility managers to address issues before they cause a service interruption. This level of planning transforms the lift station into a truly mission-critical infrastructure component.

Permitting and Regulatory Compliance for Wastewater Systems

The design and construction of a wastewater lift station are subject to rigorous oversight from multiple regulatory bodies. The project will require approvals from the local utility provider or sewer authority, the local health department, and often a state environmental agency. The permit submittals typically include a detailed engineering report, signed and sealed construction drawings from a Professional Engineer, pump and equipment specifications, and an operations and maintenance plan. These agencies review the design for compliance with public health standards, environmental protection rules, and the utility’s specific construction standards. The review process scrutinizes everything from pipe materials and backflow prevention to alarm systems and emergency overflow capacity. Permitting requirements vary by jurisdiction, and every project team should confirm the applicable standards with the local, state, regional, and federal authorities that hold review authority over the site. Proactive agency review and clear communication are essential to navigate this complex process and avoid delays that could impact the project’s overall timeline and budget for environmental compliance.

Siting, Access, and Maintenance Considerations

The physical location of the lift station on the data center campus is a critical site plan design decision with long-term operational implications. The station must be positioned at a low point on the site to collect wastewater via gravity but must also consider several other factors. Setbacks from occupied buildings are necessary to minimize potential impacts from noise and odor, even with modern odor control systems in place. Crucially, the design must provide clear and robust maintenance access. This includes an all-weather access drive capable of supporting heavy vehicles like vactor trucks, which are used for periodic wet well cleaning. The area around the control panel and wet well hatches must be clear of obstructions, well-lit, and compliant with safety standards. Security is another consideration; the lift station should be located within the site’s secure perimeter to prevent tampering. Careful planning of the station’s location and access ensures that routine maintenance and emergency service can be performed safely and efficiently, protecting the long-term reliability of this vital infrastructure.

Our Process: A Systematic Approach to Lift Station Engineering

At RSP Engineers, we approach lift station design for mission-critical facilities with a rigorous, phased process to ensure reliability and compliance. Our methodology begins with a detailed feasibility study, including comprehensive utility coordination to identify connection points and capacity constraints. We then move to preliminary engineering, where we perform detailed flow calculations and develop initial site plan design concepts that balance hydraulic requirements with site logistics. Once a concept is approved, our team develops a full set of construction documents, specifying every component from the pumps and controls to the concrete and coatings. We manage the entire permitting process, interfacing with all reviewing agencies to secure timely approvals. During construction, we provide construction administration services, including submittal reviews, site inspections, and oversight of system startup and commissioning. This end-to-end management ensures the final product meets the exacting standards required for a data center environment.

Common Challenges in Lift Station Implementation

Even with careful planning, lift station projects can encounter challenges. Unforeseen subsurface conditions, such as rock or a high water table discovered during a Geotechnical Engineering investigation, can complicate excavation for the wet well and increase construction costs. Supply chain issues can cause long lead times for specialized pumps, motors, and control panels, requiring early procurement and flexible construction sequencing. Complex utility coordination with power and communications providers is another common hurdle, as the lift station requires its own dedicated services. Finally, pressure for value engineering can sometimes lead to suggestions that compromise long-term reliability, such as using lower-grade materials or omitting redundant features. Our role as the project’s Professional Engineer is to help clients navigate these challenges, making informed decisions that prioritize the facility’s operational integrity over short-term cost savings. Frequently Asked Questions What is the typical lifespan of a lift station? A well-designed and properly maintained lift station can have a long service life. The concrete wet well structure can last 50 years or more, especially if protected with a corrosion-resistant coating. Mechanical components like submersible pumps and valves typically have a lifespan of 15-25 years, depending on usage and maintenance frequency. The electronic control panel may require updates or replacement on a 10-15 year cycle as technology evolves. Who is responsible for maintaining the lift station after construction? Typically, the property owner—in this case, the data center operator—is responsible for the ongoing ownership, operation, and maintenance of a private lift station. This is a key point to clarify during the design phase. Some local utilities may offer a maintenance contract, but it is more common for the facility to handle it in-house or through a specialized third-party contractor. A comprehensive Operations and Maintenance (O&M) manual is a critical deliverable from the engineering team. How are odors and noise managed? Odor is managed primarily through proper wet well design that prevents sewage from becoming septic and by installing either passive or active ventilation systems with carbon filters or biological scrubbers. Noise is generally minimal as the pumps are submersible and operate below ground. The primary source of noise is the control panel’s cooling fans or an external alarm horn, which can be mitigated through careful placement and selection of low-noise equipment. Can a lift station be expanded if our data center grows? Yes, future expansion can be planned for during the initial design. This can involve designing a larger wet well than immediately needed, installing pump guide rails for additional future pumps, and sizing the force main to handle increased capacity. Planning for expansion upfront is far more cost-effective than retrofitting a system later and avoids significant operational disruption. What kind of alarms are standard for a data center lift station? For a data center, the alarm system must be robust. Standard alarms include high water level in the wet well, pump failure, and loss of power. These alarms should trigger both a local visual/audible alarm (strobe/horn) and send remote notifications to the facility’s Building Management System (BMS) or directly to maintenance personnel via an autodialer or IP-based system. This ensures immediate awareness and response to any off-normal condition.

Your Partner in Mission-Critical Site Engineering

Designing and permitting a lift station for a remote data center requires a specialized skill set that blends traditional civil engineering with a deep understanding of mission-critical facility requirements. The stakes are too high to rely on a standard commercial design. The team at RSP Engineers has the expertise to navigate the complexities of utility design, agency approvals, and resilient infrastructure planning. Contact us to ensure your facility’s wastewater system is as reliable as its power and cooling. We provide comprehensive site engineering services to support your project from concept through commissioning.

Conclusion

A sewage lift station is more than just a necessary utility; for a remote data center, it is a cornerstone of operational continuity. Successful implementation hinges on a design philosophy that prioritizes redundancy, resilience, and long-term maintainability. By focusing on detailed capacity calculations, robust backup power integration, and proactive permitting strategies, developers can mitigate significant operational risks. Ultimately, a well-engineered lift station is a critical investment in the uptime and success of any mission-critical site development project.
