High-Groundwater Challenges on Data Center Sites
Explore key civil engineering challenges for data center development on sites with high groundwater. Learn about dewatering, buoyancy risks, stormwater design, and mitigation strategies.
Identifying High Groundwater During Site Due Diligence
The first line of defense against groundwater-related issues is a thorough investigation during the due diligence phase. Identifying the presence and elevation of the seasonal high water table (SHWT) is a critical data point that informs the entire site plan design. Relying solely on surface observations is insufficient; a comprehensive Geotechnical Engineering investigation is non-negotiable for any serious data center prospect. This investigation is the foundation of a sound engineering approach. A qualified Geotechnical engineer will perform a series of soil boring test procedures across the site to collect soil samples and measure groundwater levels. This data is compiled into a detailed Geotechnical soil report, which establishes the SHWT and characterizes the soil’s properties, such as permeability and bearing capacity. This report is arguably one of the most important documents in the early stages of site development, as it directly influences foundation design, utility routing, and the feasibility of the proposed grading and stormwater management plan.
Structural and Buoyancy Risks for Underground Infrastructure
Comparison of Groundwater Mitigation Strategies
| Strategy | Primary Application | Key Considerations | Relative Cost |
|---|---|---|---|
| Raising Site Grade | Overall site elevation, creating separation for buildings and infrastructure. | Requires large volumes of suitable fill, potential for settlement, extensive earthwork. | High |
| Foundation Underdrains | Protecting building slabs and below-grade walls from hydrostatic pressure. | Requires a discharge point (gravity or pumped), long-term maintenance of sumps. | Moderate |
| Extensive Waterproofing | Basements, utility vaults, and below-grade structures to prevent water intrusion. | Requires meticulous installation; difficult to repair if it fails. | Moderate |
| Shallow Foundation Design | Building structures (e.g., mat slabs) to minimize excavation depth. | Dependent on structural loads and soil bearing capacity; may not be feasible for all buildings. | Low to Moderate |
| Construction Dewatering | Temporary water table lowering during the construction phase for all excavations. | Requires permits, continuous operation, and can be costly for long durations. | Varies (Moderate to High) |
One of the most direct physical threats from high groundwater is hydrostatic pressure, which creates buoyant forces that can lift or damage underground structures. Data centers rely on extensive buried infrastructure, including large fuel storage tanks for backup generators, water tanks for cooling or fire suppression, and large utility vaults. If these structures are not designed to resist uplift, they can be pushed out of the ground, shearing connections and causing catastrophic failures. This is a major concern for site engineering services. Effective civil engineering design must include anti-buoyancy calculations for all submerged or partially submerged structures. Mitigation measures often include pouring heavy concrete collars or dead-man anchors over tanks, using helical anchors to tie structures down, or simply specifying heavier-walled vaults. Furthermore, persistent groundwater can lead to water intrusion into underground duct banks and manholes, compromising critical power and fiber optic conduits. Robust waterproofing and sealed conduit systems are essential components of the utility coordination plan to ensure long-term reliability.

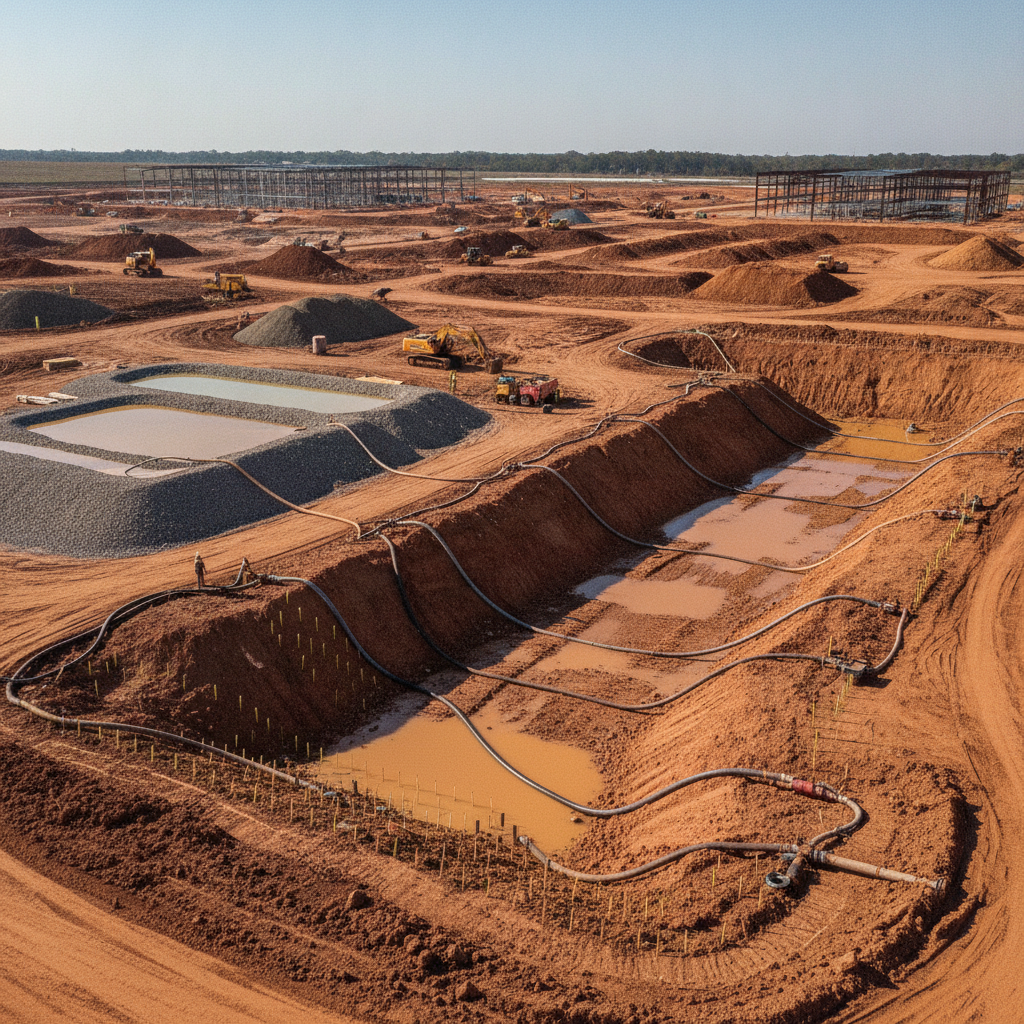

Excavation Dewatering and Associated Permitting
Constructing deep foundations, utility trenches, and basements on a site with a high water table is impossible without first removing the groundwater from the excavation area. This process, known as construction dewatering, involves pumping large volumes of water to temporarily lower the water table. Common methods include sump pumps for minor inflows, wellpoint systems for larger areas, and deep wells for significant drawdown requirements. The complexity and cost of the dewatering system are directly tied to the site’s soil permeability and the depth of excavation. Dewatering is not just a construction logistics issue; it is also a significant regulatory hurdle. The pumped groundwater must be discharged somewhere, and this discharge is typically regulated under the federal Clean Water Act’s NPDES program or equivalent state and local programs. Permitting requirements for construction dewatering vary by jurisdiction, and every project team should confirm the applicable standards with the local, state, regional, and federal authorities that hold review authority over the site. This process often requires water quality testing, the development of a dewatering plan, and potentially treatment of the water before it can be discharged to a storm sewer or surface water body. Failure to secure the proper permitting can lead to project delays and substantial fines.
Constraints on Stormwater Management System Design
High groundwater severely restricts options for stormwater management, a cornerstone of modern land development. Many jurisdictions encourage or require the use of infiltration-based practices, such as infiltration basins, permeable pavements, and bio-retention swales, to recharge groundwater and reduce runoff. However, these systems are not viable when there is insufficient vertical separation between the bottom of the facility and the seasonal high water table. Without adequate separation, stormwater cannot percolate into the ground, and the system will fail to function as designed. This constraint forces the drainage design to rely on surface storage methods like wet or dry detention ponds, which consume significant land area that could otherwise be used for building expansion or parking. In some cases, complex and costly underdrained filtration systems may be necessary. The inability to use infiltration can make it more difficult to meet water quality and quantity control regulations, requiring larger pond footprints and more intricate hydraulic control structures. This directly impacts the overall site plan design and project density.
Design Strategies for Mitigating High Groundwater Impacts
When a high-groundwater site is unavoidable, several proven civil engineering strategies can be implemented to mitigate the risks. The most common approach is to raise the entire site grade by importing structural fill. This physically increases the separation between the building foundation, utilities, and the water table. While effective, this solution involves significant earthwork costs, potential long-term soil settlement considerations, and additional permitting for fill placement, especially near sensitive environmental resources. Another key strategy is the installation of a foundation underdrain system. This network of perforated pipes, wrapped in filter fabric and bedded in clean stone, is placed below the building slab and around foundations. The system collects groundwater and conveys it to a sump or daylighted discharge point, actively relieving hydrostatic pressure on the structure. For underground utilities and structures, enhanced waterproofing, vapor barriers, and specifying watertight materials are critical. Finally, adapting the building’s structural design to use shallower foundations, such as a mat slab, can minimize the depth of excavation and reduce interaction with the highest groundwater zones, simplifying the construction administration process.
The RSP Engineers Approach to High-Groundwater Sites
At RSP Engineers, we address high-groundwater challenges with a proactive, data-driven methodology. Our process begins with a rigorous due diligence assessment, where we work closely with a Geotechnical engineer to interpret the Geotechnical soil report and identify potential risks before they become costly problems. We believe in an integrated design approach, facilitating early collaboration between our civil engineering team, the structural engineer, and the architect to develop a holistic solution. Our team develops a comprehensive site plan design that strategically balances earthwork, foundation requirements, utility coordination, and stormwater management. We model various mitigation strategies to find the most cost-effective and resilient solution for the specific project needs. We also lead the complex permitting efforts associated with dewatering and site modifications, engaging with regulatory agencies early to establish clear compliance pathways and keep the project on schedule.
Common Issues and Construction Phase Challenges
Even with excellent design, high-groundwater sites present unique construction challenges. One of the most common issues is encountering a water table higher than anticipated in the Geotechnical soil report, often due to seasonal fluctuations or localized perched water. This can necessitate emergency changes to the dewatering plan. Another significant risk is the failure of a dewatering system, which can flood an excavation, compromise soil stability, and cause significant delays. During construction, strict adherence to dewatering permit conditions is crucial. Improper discharge can result in stop-work orders and fines. For sites where the grade is raised, ensuring the quality of imported fill and achieving proper compaction are essential to prevent long-term settlement that could damage slabs, pavements, and utilities. Effective construction administration and quality control are paramount to verifying that all mitigation systems are installed correctly and functioning as designed before they are buried and inaccessible. Frequently Asked Questions (FAQ) What is a seasonal high water table (SHWT) and why is it important? The SHWT is the highest level that groundwater is expected to reach during the wettest time of the year. It is a critical design parameter determined by a Geotechnical engineer because it dictates foundation design, the feasibility of basements, stormwater management strategies, and the need for waterproofing and underdrain systems. Can we use infiltration for stormwater management on a high-groundwater site? Generally, no. Infiltration-based systems require a minimum vertical separation distance between the bottom of the system and the SHWT to function properly. On high-groundwater sites, this separation is often not achievable, forcing the drainage design to rely on detention ponds or other non-infiltrating methods. What kind of permits are needed for construction dewatering? Discharging pumped groundwater typically requires a permit under the National Pollutant Discharge Elimination System (NPDES) program or a similar state or local authorization. The specific permitting process depends on the volume of water, its quality, and where it is being discharged. Requirements vary significantly by location. How does high groundwater affect the project schedule and budget? High groundwater can significantly increase costs and extend schedules. Budget impacts come from dewatering operations, imported fill, foundation underdrains, and more robust waterproofing. Schedule delays can arise from the time required to obtain dewatering permits and the added complexity of excavating and building in wet conditions. Is it better to avoid high-groundwater sites altogether? While a site without high groundwater is preferable, it’s not always an option. With proper investigation and expert civil engineering design, the challenges are manageable. The key is to identify the conditions early during due diligence to accurately budget for the necessary mitigation measures.
Partner with RSP Engineers for Your Mission-Critical Development
Navigating the complexities of a high-groundwater site requires specialized expertise and a forward-thinking approach. The team at RSP Engineers has a proven track record of delivering successful data center projects on challenging sites across the country. We provide comprehensive site engineering services, from initial feasibility and due diligence through final design, permitting, and construction administration. Don’t let subsurface conditions jeopardize your investment. Contact us today to discuss how our civil engineering expertise can bring certainty and value to your next mission-critical project.
Conclusion
High groundwater presents a formidable set of challenges for data center site development, but they are not insurmountable. Success hinges on early and accurate site investigation, a fully integrated design process, and the implementation of proven engineering solutions. By addressing issues like buoyancy, dewatering, and stormwater management constraints head-on, developers can mitigate risks and build resilient facilities. Partnering with an experienced civil engineering firm is the most critical step in transforming a challenging site into a high-performing asset.
FAQs
-
High-Groundwater Challenges on Data Center Sites requires careful planning, qualified engineering, and compliance with the applicable codes and permits.
-
Getting High-Groundwater Challenges on Data Center Sites right protects safety, supports regulatory compliance, and avoids costly redesigns or delays.
-
RSP Engineers provides licensed expertise and end-to-end support for High-Groundwater Challenges on Data Center Sites, from early planning through permitting.
